Villa demolition, Dubai

Villa demolition in Dubai and the UAE

Taking a villa down, or part of it, needs its own permit, a contractor graded for demolition, the utilities disconnected properly and the rubble taken where the rules say. We line those up before demolition contractors price the job.

The job

Villa demolition: full, partial or a strip-out?

Villa demolition covers three different jobs. A full demolition clears the plot for a new villa. A partial one removes a piece of the building, an old annex, a wall between two rooms or a garage, to make room for something else. A strip-out takes the finishes back to the structure before a renovation. The permits follow that split, and so does the price.

How much does villa demolition cost in Dubai?

The published costs are the permits, from free for DEWA's demolition approval to AED 2,400 for Tasareeh's single-villa demolition review in Abu Dhabi, with Ajman's demolition permit at AED 1,000 in between. No UAE company publishes a demolition rate we can quote as a band, so the works are priced from demolition contractors' answers to one brief: built-up area, structure, what stays, access to the plot and where the rubble goes. A strip-out ahead of a full villa renovation is priced inside that job, which UAE companies publish from about AED 150,000.

Which permits does a villa demolition need in Dubai?

On a Municipality plot, taking a villa down runs on the Municipality's Permit to Carry Out Demolition Works, valid for three months, and a renewal is issued instantly if the work runs over. The Municipality regulates demolition permitting under its own 2025 circular. Where demolition is part of a modification, the drawings for the Permit to Make Modifications or Additions to Buildings mark the parts to be taken down in green.

The contractor matters as much as the permit. In Dubai Municipality's contracting classification, Wrecking and Demolition Works (activity 451001) is a main activity with its own grades, the same standing as building contracting, so a fit-out or maintenance firm cannot simply take a villa down. On Nakheel land, partial demolition sits inside the Trakhees modification route, set out on our Dubai regulators map.

Send us the plot and the scope

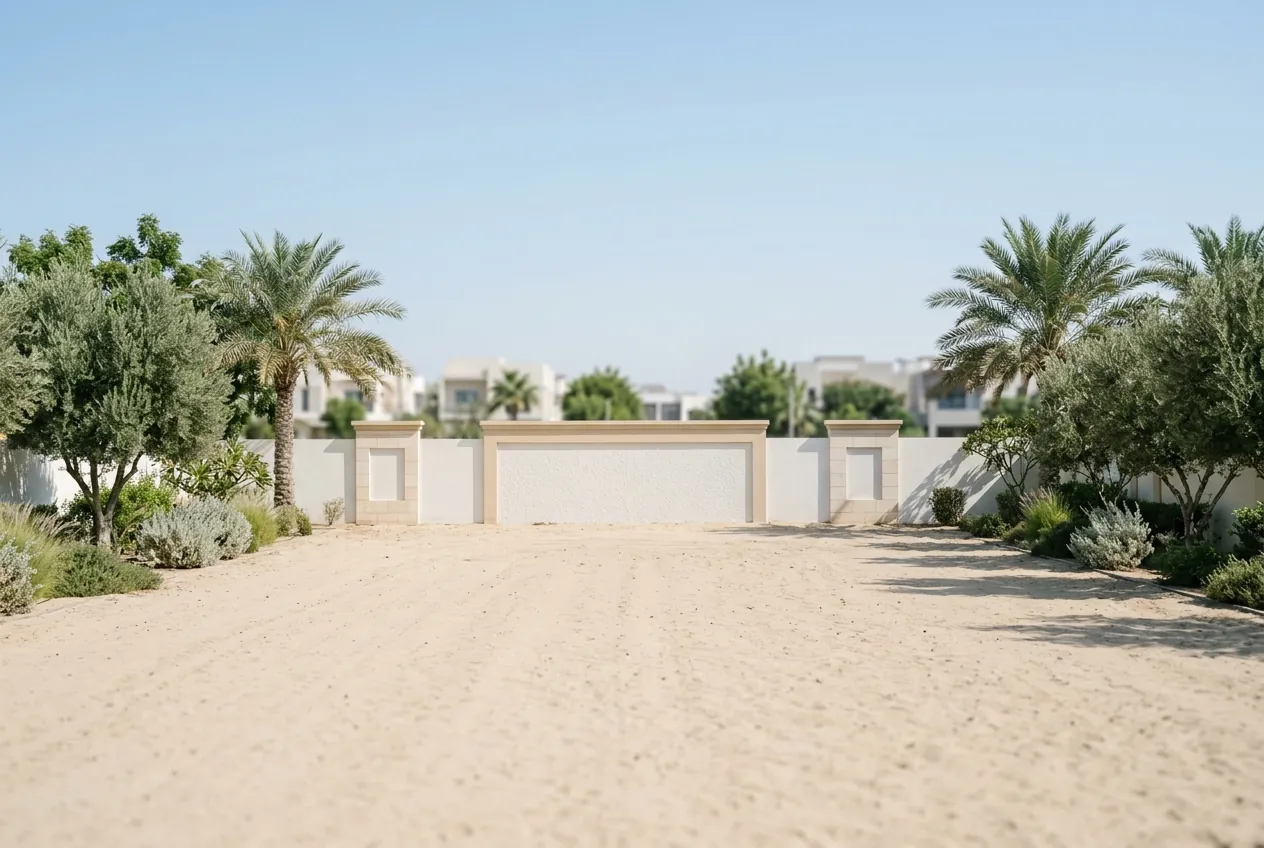

A cleared, sandy residential plot bordered by a white boundary wall, palm trees, and desert landscaping

Utilities, noise and the site

  • Electricity and water. DEWA's Demolishing Permits service is free and gives a combined approval in 10 working days, and only a DEWA-enrolled demolition contractor may apply.
  • Noise. Dubai Municipality's safety guide applies the noise chapter of Local Order No. 61 of 1991 to demolition as well as building, and noisy work between 8 PM and 6 AM needs a night work permit.
  • Trucks and roads. In Dubai Holding communities, large vehicles need 48 hours' notice, loading finishes the same day and the road is cleaned within an hour.
  • Rubble. Construction waste goes to Dubai Municipality-approved disposal areas, as the Dubai Holding rules spell out.
  • Summer. From 15 June to 15 September, work in direct sun stops from 12:30 to 3 PM.

Dubai Municipality also publishes a separate circular on fencing demolition sites, so a hoarding line belongs in the quote. Town Square treats breaking or opening interior walls in a townhouse as a major alteration, with an AED 2,000 fee and an AED 5,000 deposit.

What does Abu Dhabi publish for a villa demolition?

More than Dubai does. TAMM lists Issuing Demolition Permit at 17 working days and AED 600. On plots in the scope of Tasareeh, Aldar's delegated permit reviewer, a single-villa demolition review is AED 2,400, AED 600 architectural and AED 1,800 structural, and each work start notice AED 600. The contractor, not the owner, answers for a demolition permit, and the classified activity is Demolition of Buildings and Lifting of Construction Rubbles (4311001).

Abu Dhabi also shows where demolition is refused. Its Capital Development Code allows no development, demolition included, except in compliance with the code, and the 2025 rulebook for the Al Falah complex does not allow existing villa structures to be demolished except to connect an extension. Rubble in the wrong place carries the largest published fine: Administrative Decision No. 220 of 2024 fines dumping construction debris where it is not allowed AED 100,000 for a first offence. The route for extensions is on our extending a villa page, and the emirate's permits in our Abu Dhabi guide.

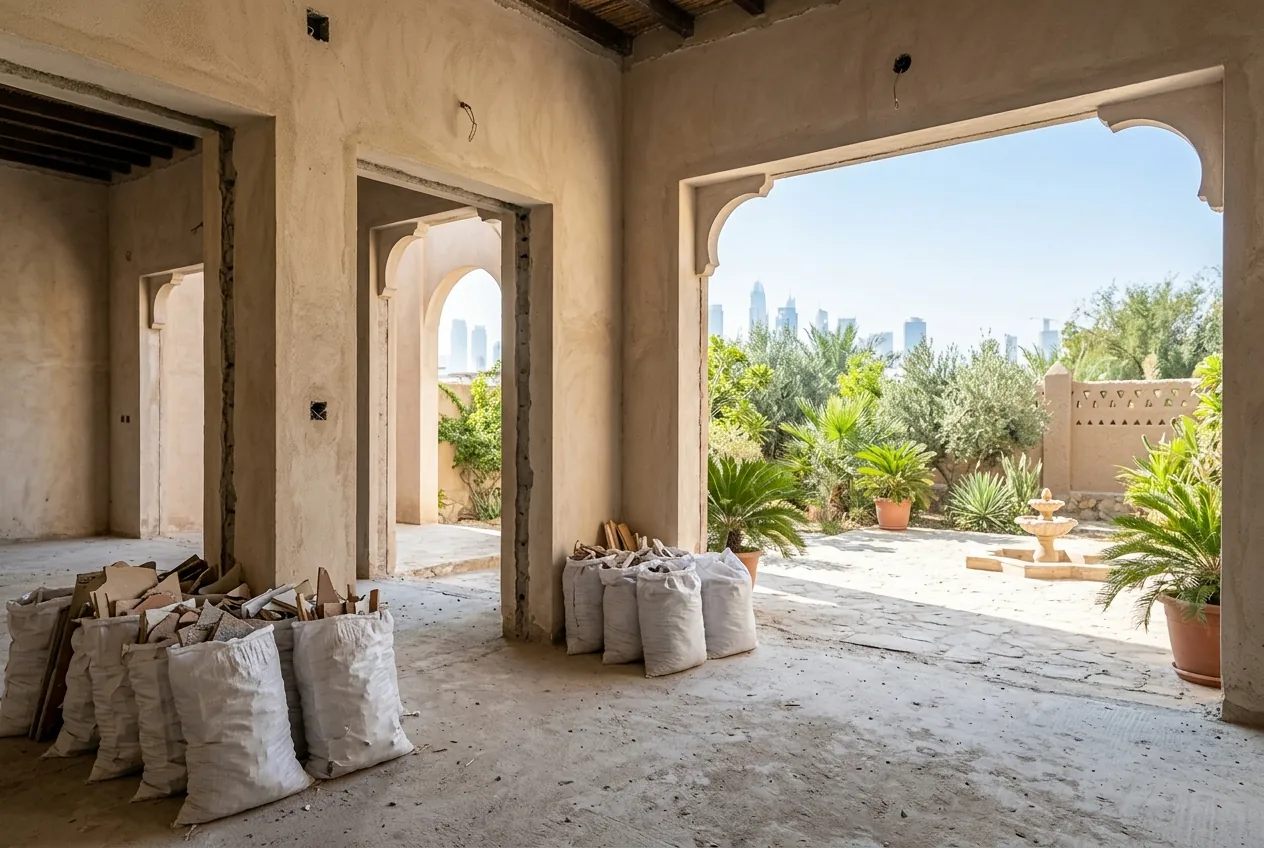

Stripped interior of a villa under renovation with bags of rubble and an open view to a sunny courtyard garden

Villa demolition in Ajman and Sharjah

Ajman's Demolition Permit Request costs AED 1,000 and takes 2 days, and only contracting companies apply. The file needs no-objection letters from Etihad Water and Electricity, the Ajman Sewerage Company, Etisalat and the Rental Disputes Committee, the last to show tenants have been dealt with, plus a contract between the demolition company, the owner and the consultant. The permit's deposit comes back through Ajman's insurance refund service within 7 days; the rest of the schedule is on our Ajman demolition permit page. Sharjah publishes no villa demolition fee, and its Municipality sets building fees file by file, so we confirm the cost per job.

What should a villa demolition quote include?

  1. The method statement: how the structure comes down, in what order, and with what machinery.
  2. What stays: boundary walls, retaining walls, trees, the neighbour's shared wall, any part of the villa being kept.
  3. The utility disconnections, who applies for each, and when.
  4. Hoarding, dust and noise control, and the working hours the programme assumes.
  5. Rubble removal: the transporter, the approved disposal site and the number of loads.
  6. Every permit and deposit on its own line, and the insurance the contractor carries.

Demolition is rarely the end of a project. What comes after decides how much should go, which is why we brief it together with the rebuild or the complete renovation that follows.

Ask for a demolition quote

Scope

Three demolition jobs we brief

Full villa demolition

Clearing the plot for a new villa: permits, utility disconnection, hoarding, demolition and the rubble removed to an approved site.

  • Graded contractor
  • DEWA approval
  • Approved disposal

Partial demolition

An annex, a garage, a wall between rooms or a rear fence taken down to make way for new work, under the modification or extension permit.

  • Marked on drawings
  • Structure checked
  • Neighbour walls kept

Strip-out

Finishes, fittings and services removed back to the structure ahead of a renovation, priced as the first line of that job.

  • Inside the renovation
  • Services isolated
  • Waste logged

More on Villa demolition in Dubai and the UAE

Questions

Villa demolition: what owners ask

Can a homeowner apply for a demolition permit?
Generally not. Ajman's demolition permit is open to contracting companies only, Abu Dhabi makes the contractor answerable for it, and DEWA accepts demolition applications only from enrolled demolition contractors. The owner signs the contract and the consents; the contractor files.
Can I knock down part of my villa to extend it?
Often, under the extension's own permit, with the part to be removed marked on the drawings. Some rulebooks limit it: the Al Falah complex in Abu Dhabi allows demolition of existing villa structures only where an extension has to connect. In Jumeirah Park, rebuilding the lake-side rear fence starts by taking down the blockwork above the retaining wall, and a solid masonry wall is not accepted in its place.
Where does the rubble from a villa demolition go?
To an approved disposal site, by a transporter who can show where the loads went. Dubai Holding's rules send construction waste to Dubai Municipality-approved disposal areas, and Abu Dhabi fines dumping construction debris in the wrong place AED 100,000 for a first offence, rising to AED 400,000.
Do I need to tell the neighbours?
For any noisy work at night, yes: Dubai Municipality's night work permit requires neighbours to be told the time, duration and type of work, with emergency contact numbers. Emaar's Arabian Ranches guidance asks owners to notify neighbours before noisy work, which is good practice everywhere.
How long is a Dubai demolition permit valid?
Dubai Municipality's Permit to Carry Out Demolition Works is valid for three months, and its renewal service is listed as instant. Plan the utility approvals inside that window: DEWA's combined demolition approval takes 10 working days.
Does a strip-out need its own permit?
Removing finishes to replace them is part of the renovation that follows, not a demolition in its own right. Removing walls is a modification. In Dubai Development Authority zones, Circular 318 of 2019 exempts non-structural demolition inside a unit from the fit-out permit.

Who you are dealing with

  • OperatorWebsiteOS LLC
  • Licence2646567.01
  • Cost to homeownerNone
  • Figures datedSeptember 2026

Tell us about the demolition

Community, plot, the villa's size and age, and whether it all comes down or only part of it. We come back with graded demolition contractors who price one brief.
